WOLFF Power for Hightech – Eight WOLFF cranes help build new Zeiss site in Jena

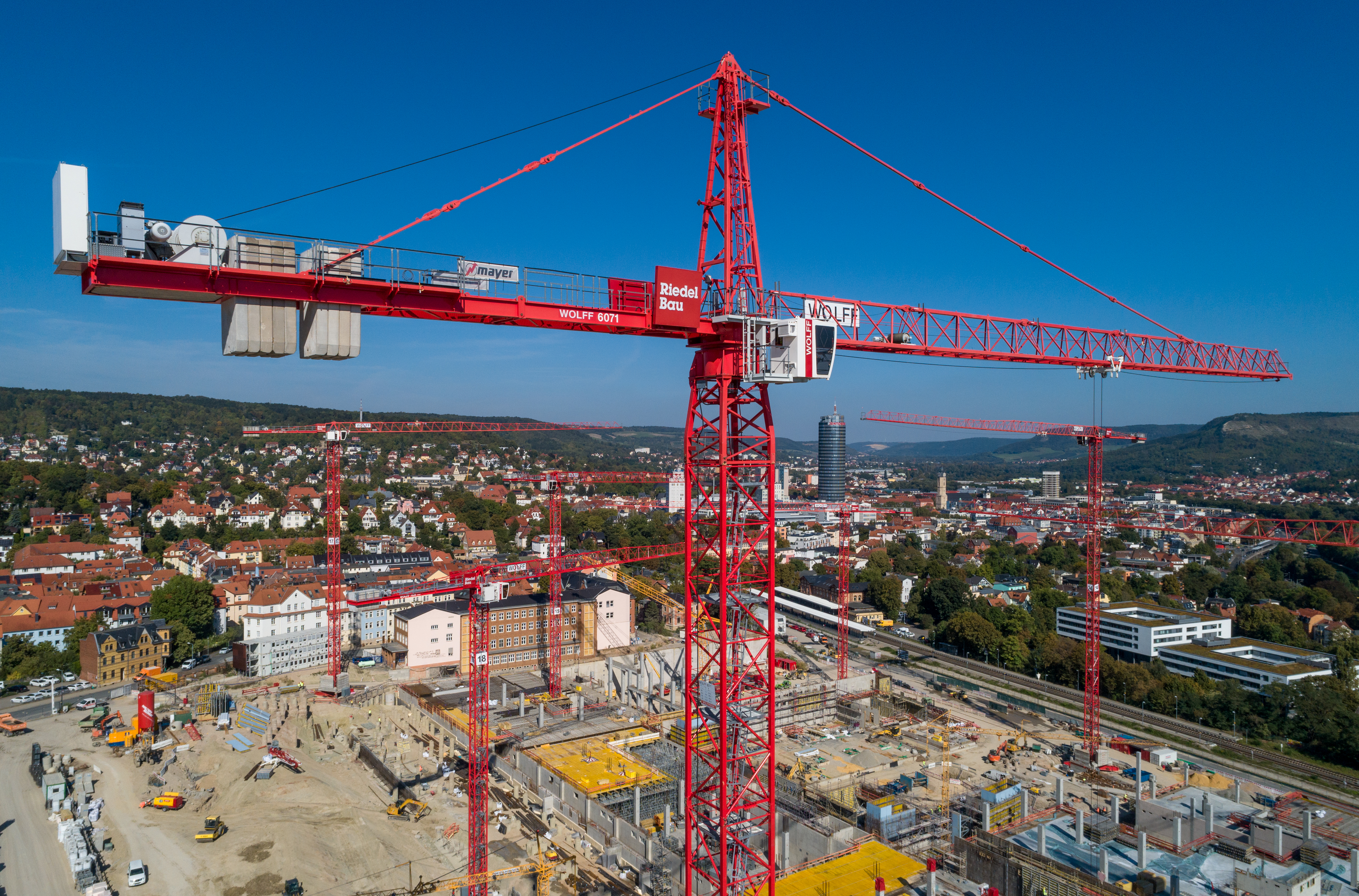

The WOLFF 6071.20 Cross is the powerhouse of the WOLFF pack on the Zeiss construction site. Its job is to lift prefabricated parts weighing up to 22 tons.
WOLFFKRAN Europe
Go to photo
The WOLFF 6071.20 Cross is the powerhouse of the WOLFF pack on the Zeiss construction site. Its job is to lift prefabricated parts weighing up to 22 tons.

IMAGE SOURCE: WOLFFKRAN International AG

  • Carl Zeiss AG is constructing a new high-tech site in Jena, Germany, with a gross floor area of 118,000 square meters, utilizing eight WOLFF cranes provided by Riedel Bau AG.

  • The construction site features seven WOLFF 7534.16 Clear cranes and one WOLFF 6071.20 Cross crane, with the latter performing heavy lifts of precast concrete parts and special lifts in overload mode under expert supervision.

  • Riedel Bau AG faced challenges in crane foundation planning, including extending building foundations and using foundation anchors for crane bases, with some foundations requiring dismantling after structural work completion.

  • The assembly of the cranes was a complex logistical task, with over 25 trucks delivering parts and three cranes being assembled almost simultaneously, facilitated by collaboration with Wolffkran and a crane logistics company.

  • A WOLFF 7534.16 Clear crane was strategically placed between lift shafts, requiring a tie-in against the lift shaft to manage calculated deflection, and a flexible tower system was used to limit deflection at the top of the lift and crane tower.

  • The eight WOLFF cranes will be used to lift various construction materials, aiming to complete the building shell by the end of 2024, with the site designed to meet the latest energy standards and full digitization, eventually housing over 2,500 employees.

Carl Zeiss AG is constructing a new high-tech site in its hometown of Jena in Thuringia, Germany, which will house all development units as well as the majority of the local production and administration departments. For the construction of this building with a total gross floor area of 118,000 square meters, the Franconian construction company Riedel Bau AG is deploying eight WOLFF cranes. The crane op- eration had to be meticulously planned and boasts countless special features.

Seven WOLFF 7534.16 Clear cranes with tip loads of between 2.9 and 7.2 tons as well as a WOLFF 6071.20 Cross with a tip load ca- pacity of 9.6 tons are being used on the 80,000 square meter con- struction site. Riedel Bau purchased two new flat top WOLFF 7534.16 Clear cranes for the mega construction site. All cranes are mounted at ultimate height, as they initially shared the construction site with five other WOLFF cranes from the pre-con- struction contractor, which had to be slewed over and were gradually replaced.

It’s all about planning: Even before the first block could be lifted onto another, one of the most complex challenges had to be solved: the founding and locations of the eight WOLFF cranes.<br>IMAGE SOURCE: WOLFFKRAN International AG

Advertisement

A powerhouse for the heaviest work

The WOLFF 6071.20 Cross, the only model with a tower top section, has a special role to play in this pack. It will transport several hundred precast concrete parts such as wall elements, columns, beams and floor slabs weighing up to 18 tons during its work. In addition, there are plans for a total of six special lifts with individual weights of up to 22 tons. The WOLFF 6071.20 Cross, which according to the tech- nical data sheet has a maximum load capacity of 20 tons, will com- plete these maneuvers under expert supervision in overload mode.

Perfectly planned from the ground up

Yet even before the first load lift was even realized, Daniel Wandelt, a work planner at Riedel Bau AG, had already faced numerous chal- lenges: “One of the biggest challenges in this project is the founding of the cranes,” he explains. “In some cases, we have extended build- ing foundations to form crane foundations. For example, we rein- forced four foundations of a parking lot deck to use them as a base for an 8x8 meter cross frame element,” explains the work planner. For five of the cranes, the crane foundations are located under other foundation components, which is why foundation anchors that re- main in the ground are the only possible solution. “Because one of these integrated foundations must be dismantled again once the structural work has been completed, we also assembled empty con- duits for a concrete saw when installing the foundation,” says Daniel Wandelt.

“The assembly of the cranes was a mammoth task in terms of plan- ning and logistics. At one point there were over 25 trucks with crane parts on the construction site, as the first three cranes were assem- bled almost simultaneously,” summarized Daniel Wandelt. “But thanks to the excellent collaboration with Wolffkran and our crane logistics company, everything has gone smoothly and according to the plan so far.”

The WOLFF 6071.20 Cross is the powerhouse of the WOLFF pack on the Zeiss construction site. Its job is to lift prefabricated parts weighing up to 22 tons.<br>IMAGE SOURCE: WOLFFKRAN International AG

Stable thanks to tie-ins and flexing tower system

With a construction site of this size and complexity, the locations of the cranes also need to be carefully considered. A WOLFF 7534.16 Clear was placed in the middle of two lift shafts, with the center wall being omitted for the time being in order to have enough space for the 2x2 meter tower. “However, as the tower has a calculated deflection of 50 cm at the planned upper end of the lift shafts and would therefore collide with the shaft walls later on in the construction process, we are planning a tie-in against the lift shaft in conjunction with Riedel Bau,” says Wolfgang Kavelius, sales execu- tive at Wolffkran. “Thanks to the flexible WOLFF tower system, we also started the tower construction with two HT 23 tower sections with a side length of 2.3 meters. The rest of the tower was con- structed with a transition piece and TV 20 tower elements. This al- lows us to limit the deflection at the top end of the lift to 12 cm and at the top edge of the crane tower from the original 90 cm to 40 cm,” says Wolfgang Kavelius.

The eight WOLFF cranes are expected to lift reinforced concrete, masonry, and prefabricated parts into place by the end of 2024. The building shell should then be completed. The building will be con- structed according to the latest energy standards and fully digitized. Once completed, it will house over 2,500 employees working in re- search, development, and production.

Source: WOLFFKRAN International AG
